Managing 20 restoration areas without losing control

Image source:
March 18, 2026

Managing one restoration area is a technical problem. Managing twenty is a governance problem.

At one site, you know the soil, the slope, the crew, the timeline. You can hold the entire project in your head. At twenty sites, spread across different properties, different stages, different biomes, different contractors, the problem is no longer "what do we do here?" It is "where are we losing ground, and how do I know before it is too late?"

What breaks at portfolio scale

The first thing that breaks is comparability. Each area generates its own data - soil analyses, progress reports, monitoring indicators, cost tracking. But unless that data follows the same structure, the same definitions, the same units, comparing site A to site B is guesswork. One site reports planting progress in hectares treated. Another reports it in percentage of total area. A third reports it in number of seedlings planted. All three numbers are correct. None of them can be compared.

The second thing that breaks is prioritization. When every site has its own issues, its own delays, its own risks, the portfolio manager faces a triage problem. Which delay is critical? Which issue will cascade into a missed planting window? Which site is quietly underperforming while the noisy site gets all the attention? Without standardized signals, the loudest problem wins - not the most important one.

The third thing that breaks is reporting. Investors want a portfolio view. Regulators want compliance evidence per site. Auditors want traceable data per zone. The board wants a summary. Each audience needs a different slice of the same data, and if that data lives in scattered PDFs, shapefiles, and spreadsheets, producing any of these reports becomes a multi-day exercise in data archaeology.

"The real problem is not the data. It is that nobody sees it in the same place. Each site has its own folder, its own format, its own person who understands it. When you manage twenty sites, that means twenty separate realities that nobody can compare." - Quentin Franque, CPO, MORFO

The Excel trap

Most portfolio managers start with what they know: spreadsheets. A master tracker with one row per site, columns for stage, area, progress, issues, next steps. It works at five sites. At fifteen, it becomes a full-time job to maintain. At twenty, it is already out of date by the time you finish updating it.

The problem is not Excel itself. It is that a spreadsheet cannot enforce data standards across sites. It cannot flag when a site has not reported in three weeks. It cannot show you that the velocity on zone Z2-W dropped 40% last week while the overall project average looked fine. It cannot link a soil analysis result to the planting prescription it informed. It stores numbers. It does not store decisions.

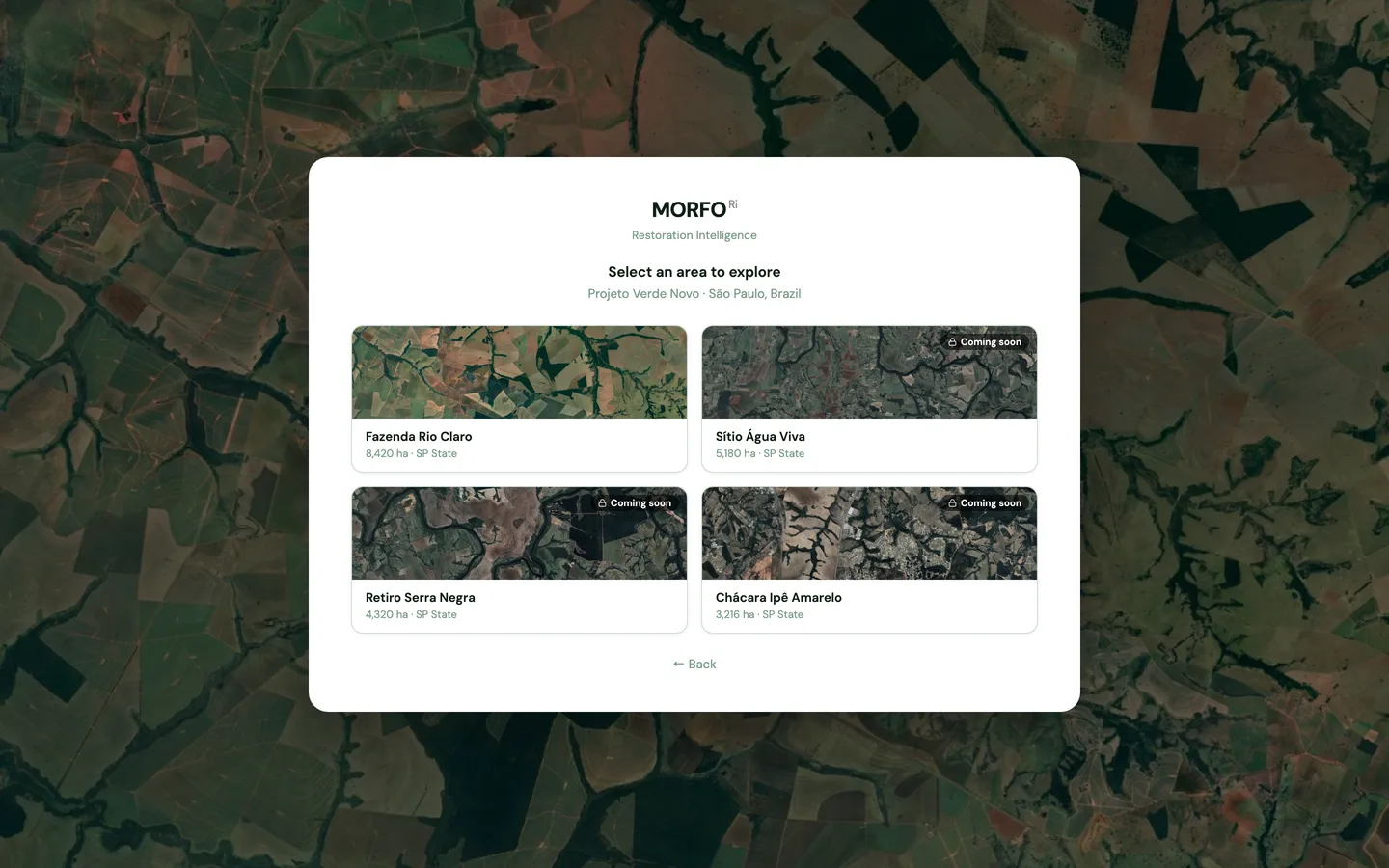

MORFO Ri - Welcome Gate

The same applies to Google Earth and GIS tools. They are excellent for spatial analysis. They are not designed to track operational progress, flag issues, compare sites, or produce investor reports. Using GIS as a project management tool is like using a microscope as a hammer - it works, technically, but everything takes longer than it should.

What "control" actually means

Control at portfolio scale does not mean knowing everything about every site. It means knowing, at any given moment, the answers to five questions:

1. Which areas are on schedule and which are behind?

2. Where are the open issues, and which ones are critical path?

3. Which sites are approaching their planting window, and are their pre-activities on track?

4. How does actual spending compare to planned budget, per site and in aggregate?

5. What evidence is ready for the next investor report, regulatory submission, or audit?

If answering any of these requires opening more than one system, calling more than one person, or waiting more than a few minutes, the portfolio is not under control. It is under the illusion of control.

"When you manage 20 areas, the problem is not the technique. It is governance. Who sees what, when, and in what format. If that is not standardized, you spend more time assembling data than making decisions." - Gregory Maitre, GM Brazil, MORFO

Each area has its own rhythm

A portfolio is not twenty copies of the same project. Each area is at a different stage: one is in pre-analysis, another in soil preparation, a third is mid-planting, a fourth is in post-planting monitoring. Their timelines do not align. Their risk profiles differ. Their budgets are at different stages of execution.

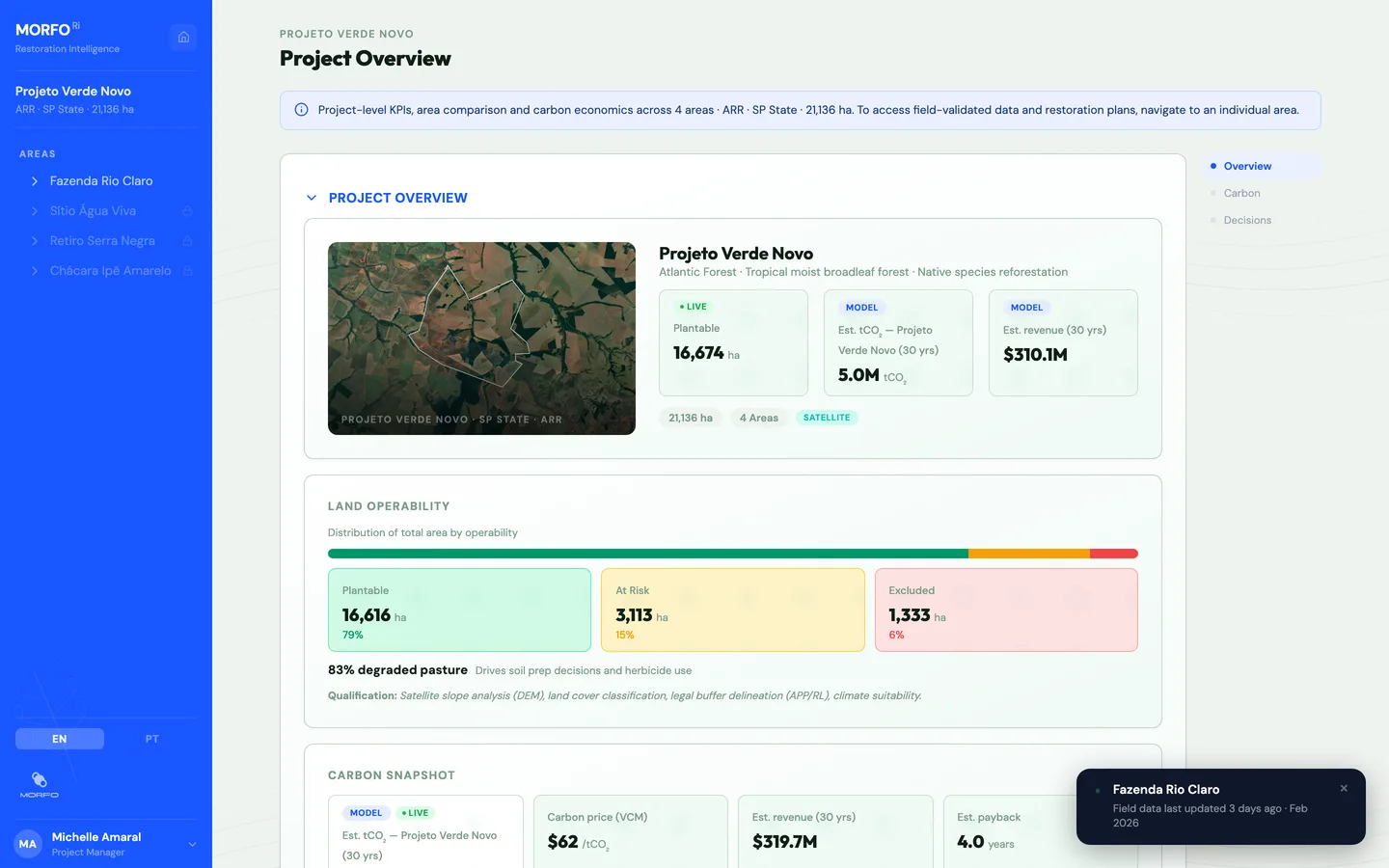

MORFO Ri - Project Overview

This means the information needed from each area changes over time. A site in pre-analysis needs diagnostic results and operability assessments. A site in planting needs daily velocity and crew tracking. A site in monitoring needs NDVI trends, species detection events, and carbon trajectory validation. The same dashboard cannot serve all stages - but the same platform must.

The structure has to flex with the stage while maintaining comparability across the portfolio. When an investor asks "how is the portfolio performing?" the answer should draw from sites at different stages without conflating a pre-analysis completion rate with a planting progress rate. Different metrics, same governance framework.

From scattered documents to structured decisions

The transition from document-based management to structured data management is the single biggest operational upgrade a restoration portfolio can make. It is not a technology choice. It is a decision about whether the portfolio will be managed by the people who happen to remember where the files are, or by a system that makes the state of every site visible to everyone who needs to see it.

Every data point carries a source. Every decision is traceable to the diagnostic that informed it. Every progress update is structured, comparable, and exportable. When someone joins the team, leaves the team, or needs to report to their board, the information is there - not in someone's laptop, not in a shared drive folder that three people know about, but in a structure that survives personnel changes and reporting cycles.

Twenty sites. Twenty different stages. One framework for decisions.

Pascal Asselin
Co-founder and General Manager
Share this article
contact us
logo-morfo
MORFO's newsletter is sent out once a month. You'll learn about worldwide and regional reforestation news, our projects, team updates, and innovations we love.
VOUS ÊTES INSCRITS À LA NEWSLETTER MORFO !
Oups ! Un problème est survenu lors de la soumission du formulaire.
